Modular Hotels in the Desert: How Resort Owners Are Building Faster in Remote Locations

  • 03 Jun, 2026
  • Industry
Modular Hotels in the Desert: How Resort Owners Are Building Faster in Remote Locations Featured Image

Resort owners are building desert hotels faster by shifting 70–80% of the construction into a factory, then shipping finished room modules to site for assembly in weeks instead of years. The result: an 80-key desert resort that would take two years with stick-built methods can open in 7–10 months using modular, with fewer workers on site, far less waste, and predictable costs even when the nearest paved road is 100 km away.

Why Desert Sites Punish Traditional Construction

Deserts eat construction schedules. Temperatures swing from 5°C at night to 48°C by afternoon, concrete cures unpredictably, adhesives fail, and workers physically cannot swing hammers between 11am and 4pm in summer. Add sandstorms that shut sites for days and supply chains that deliver cement from 400 km away, and a simple 60-room lodge becomes a multi-year ordeal.

The math is brutal. A traditional site loses roughly 25–35% of calendar time to weather and logistics in remote desert conditions. Labor turnover runs 40%+ because crews do not want to live in tents for two years. Every delay compounds — missed tourism seasons, financing extensions, and hospitality brand-launch windows that slip another year.

Modular construction sidesteps most of this by moving the hard work indoors. The factory does not care if it is 47°C outside. Quality inspectors in a controlled environment catch issues that field supervisors miss. And because modules arrive roughly 85% complete — with plumbing, electrical, tiling, furniture, and finishes already installed — the on-site window shrinks from years to weeks.

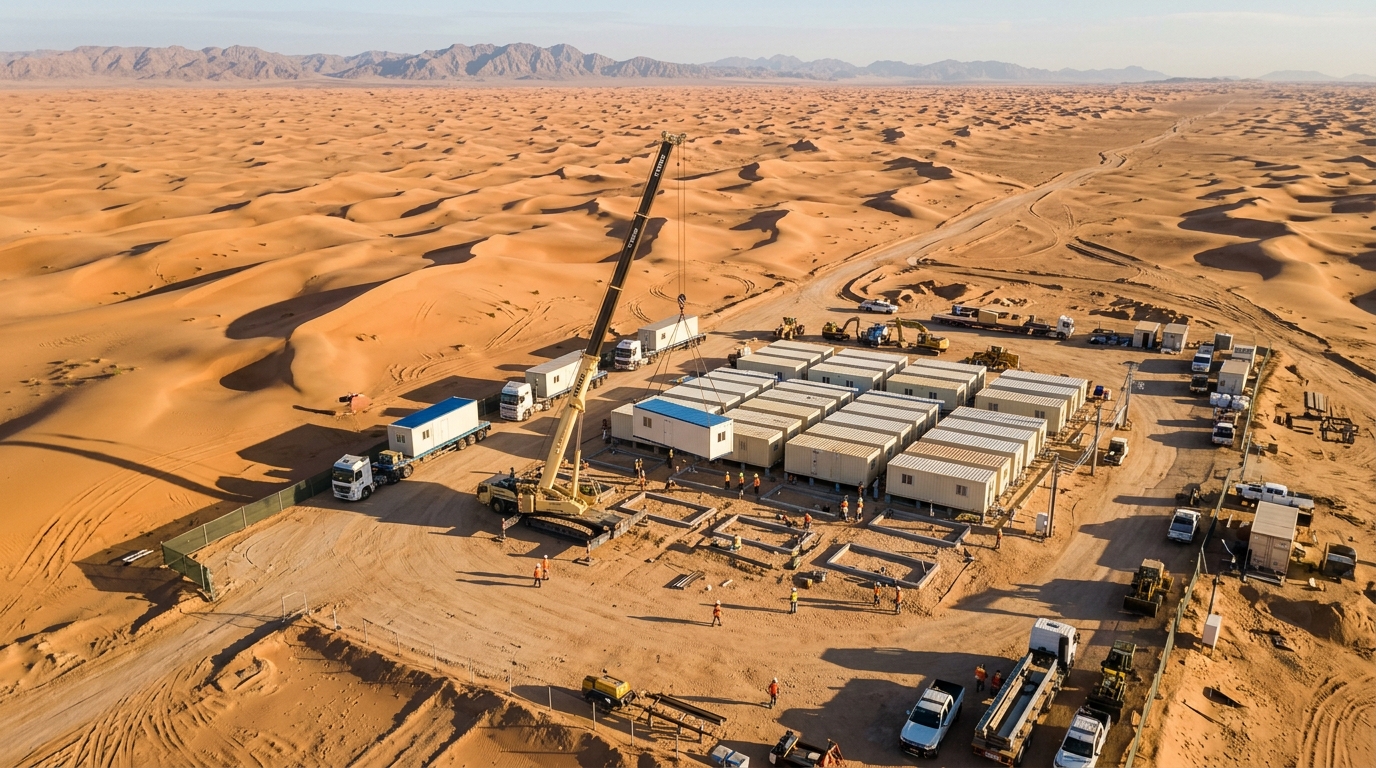

Aerial view of remote desert construction site with modular units being delivered
Aerial view of remote desert construction site with modular units being delivered

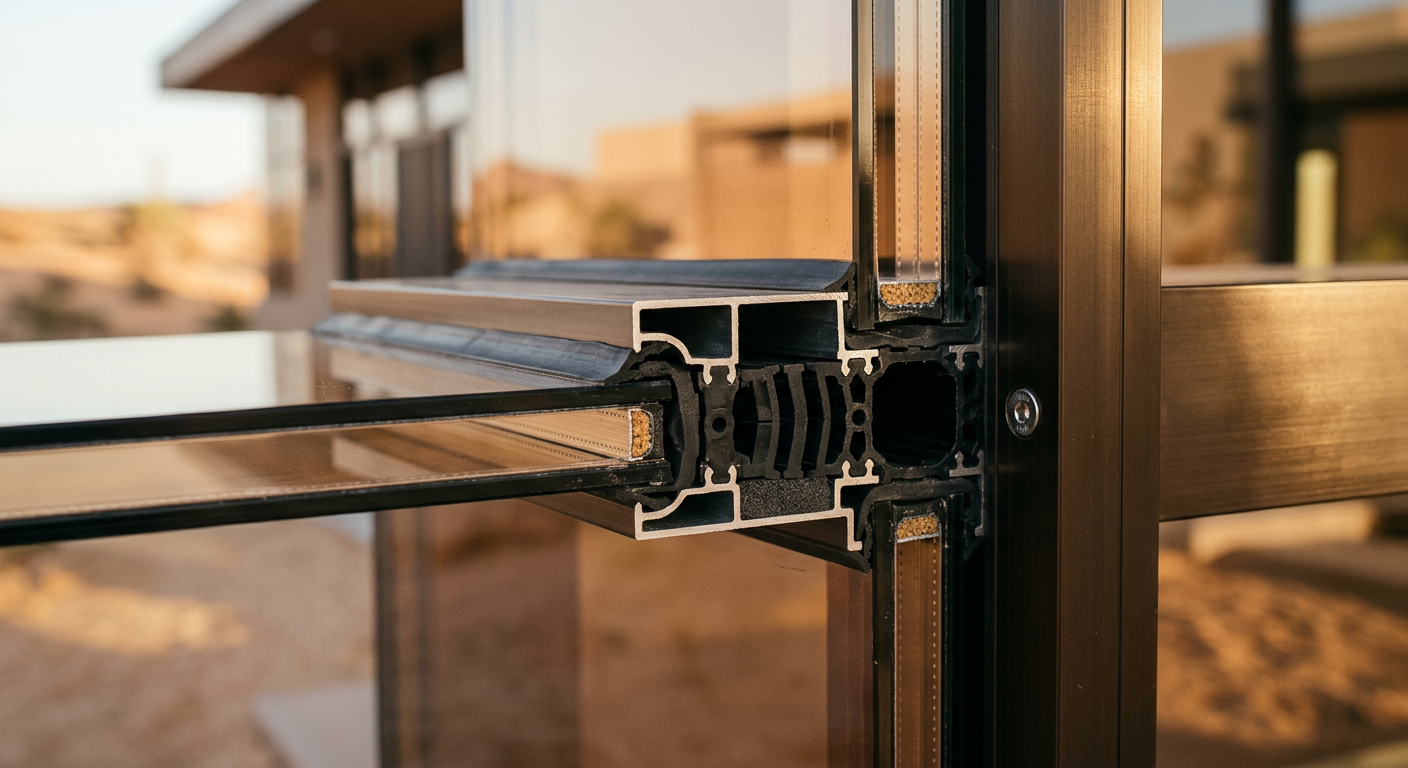

Close-up of aluminum curtain wall panel with thermal break detail
Close-up of aluminum curtain wall panel with thermal break detail

How a Modular Desert Hotel Actually Gets Built

The process breaks into four overlapping phases, and the overlap is where the time savings come from.

Phase 1: Design and engineering (6–10 weeks)

Architects work with the modular manufacturer to convert the hotel design into transportable modules — typically 3m × 12m room boxes or 3m × 6m bathroom pods. Structural loads, MEP routing, and facade systems all get engineered around module joints.

Phase 2: Site prep and factory production (run in parallel, 10–16 weeks)

This is the magic. While foundations, utilities, and roads are built on site, modules are simultaneously fabricated in the factory. You effectively compress two sequential schedules into one.

Phase 3: Transport and assembly (2–6 weeks)

Modules ship by flatbed or specialized low-loader. A 60-key hotel usually means 80–120 modules. On-site cranes stack them onto the foundation, crews connect MEP services between units, and the building is watertight within days.

Phase 4: Final fit-out and commissioning (4–8 weeks)

Lobby, pool, landscaping, facade details, and brand-specific finishes get completed. Compare that with a traditional build where commissioning alone can take six months. Our manufacturing capabilities page walks through how the factory workflow aligns with site milestones.

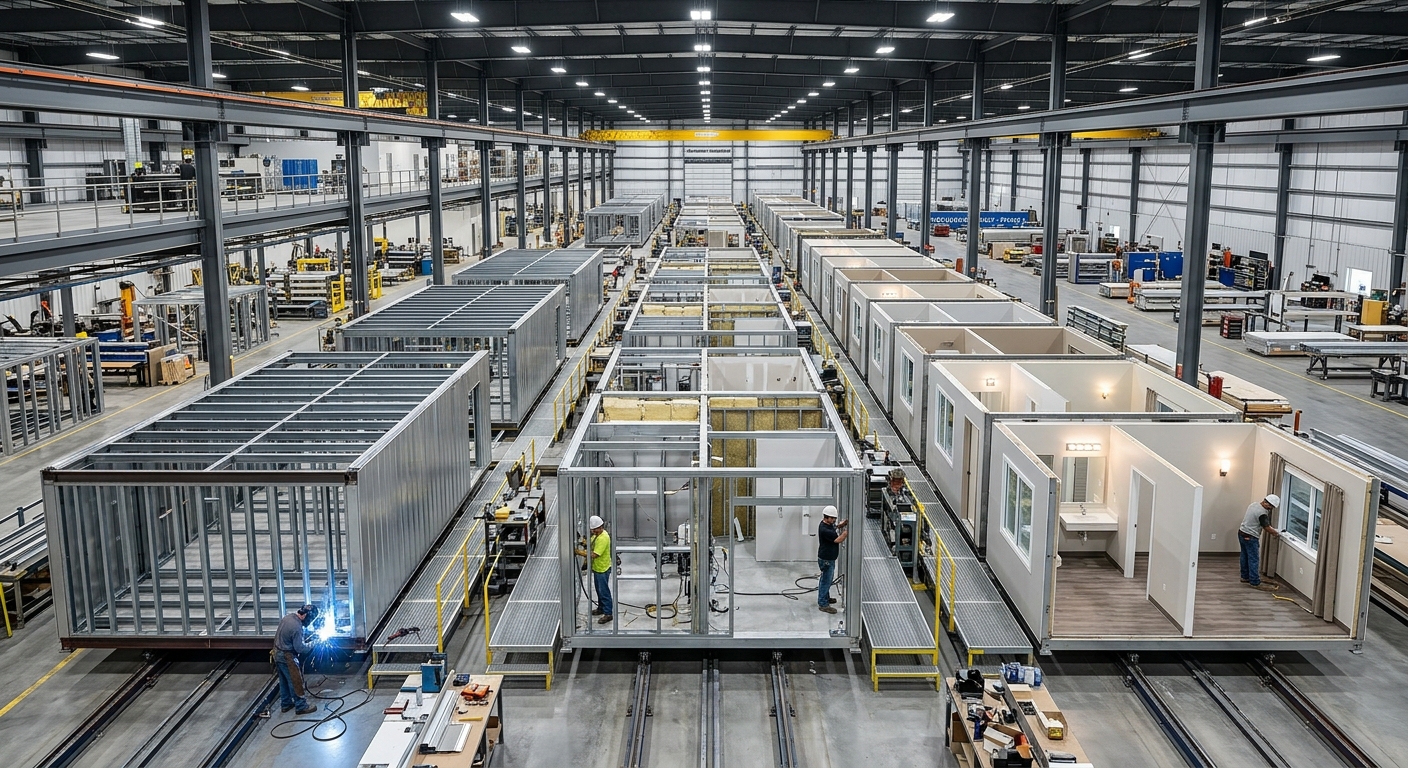

Prefab factory interior with hotel room modules on an assembly line
Prefab factory interior with hotel room modules on an assembly line

The Materials Question: Why Aluminum and Steel Win in the Desert

Timber warps. Gypsum crumbles. Concrete cracks in extreme thermal cycling. For desert modular hotels, the material choice is almost always a light-gauge steel or aluminum structural frame with high-performance insulated panels.

Why? A few specifics worth knowing:

  • Thermal performance: Aluminum curtain walls with proper thermal breaks hold U-values below 1.8 W/m²K even when outside temperatures hit 50°C. Without thermal breaks, the frame itself becomes a heat pipe straight into the guest room.
  • Sand and UV resistance: Anodized or PVDF-coated aluminum shrugs off 15+ years of blowing sand with almost no visible wear. Painted steel in the same environment needs repainting every 3–5 years.
  • Transport weight: Aluminum modules weigh roughly 30–40% less than equivalent steel-concrete, which matters when you are trucking 120 units across 300 km of desert haul road.

We cover the specific curtain wall detailing in our guide on specifying curtain walls for Middle East climates — the thermal break and gasket selection drives more operational cost than most owners realize.

Real-World Example: A 96-Key Eco-Lodge in the Arabian Peninsula

Consider a boutique desert resort developer who wanted a 96-key eco-lodge on a protected dune site 140 km from the nearest city. Traditional bids came in at 22 months and around USD 18M, with significant risk premium baked in for weather and logistics.

The modular route looked different:

  • Design lock: Week 8
  • Factory production start: Week 10 (overlapped with site works)
  • First module on site: Week 22
  • Structural assembly complete: Week 28 (96 modules stacked in 19 working days)
  • Soft opening: Week 38

Total schedule: about 9.5 months. Peak on-site headcount never exceeded 55 workers, against 200+ for the traditional approach. The owner captured a full tourism high season that would have been lost to delays. This is a pattern we see repeated across hospitality applications in remote regions.

Was everything smooth? No. The first transport convoy had to reroute 60 km because a seasonal wadi flooded unexpectedly. But that one-week delay is trivial compared to the typical three-month slip on a traditional desert build.

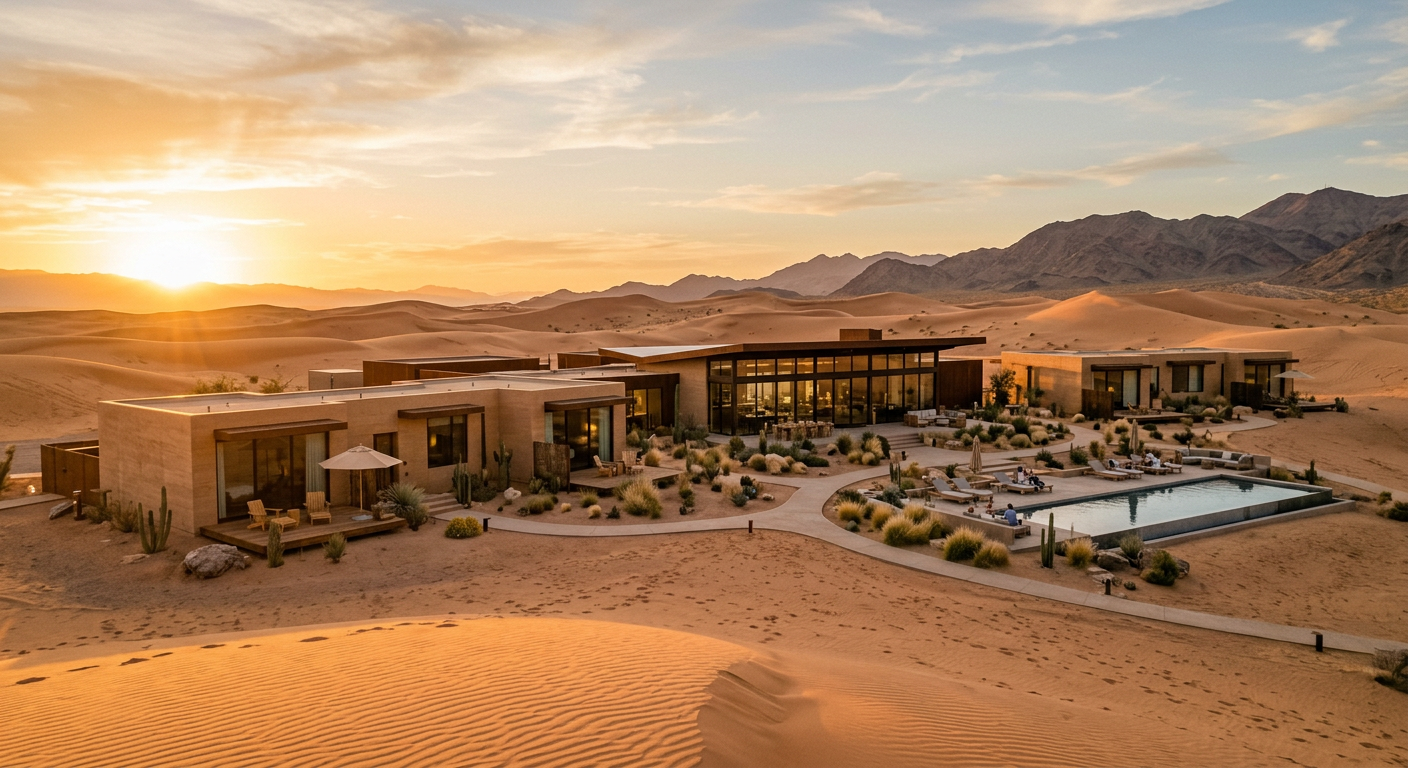

Completed modular desert eco-lodge at sunset blending into the dunes
Completed modular desert eco-lodge at sunset blending into the dunes

Logistics: The Part Nobody Talks About Until It Bites

Here is the thing that kills first-time modular hotel projects in remote locations: the road. Before you commit to 3.6m-wide modules, somebody needs to actually drive the route.

What to check before finalizing module dimensions

  • Turning radii: Can a 16m flatbed trailer negotiate every switchback? Desert tracks are often built for 4x4s, not articulated lorries.
  • Bridge weight limits: Many rural bridges are rated for 20 tonnes. A loaded module plus trailer can hit 35–40 tonnes.
  • Overhead clearances: Power lines, pipeline crossings, and fuel-station canopies have caused more than one expensive redesign mid-project.
  • Customs and escort requirements: Oversize permits in GCC countries typically require police escort and restrict transport to 10pm–5am in summer.

The practical answer: size modules to the road, not the architecture. A good manufacturer offers modules in multiple widths (2.4m, 3.0m, 3.6m, 4.0m) so design can adapt to the logistics reality. If the haul route limits you to 3m wide, you build a beautiful hotel with 3m modules. Fighting the road never ends well.

Cost Reality: Where Modular Saves, Where It Does Not

Modular is not automatically cheaper. On a straight per-square-meter basis at a well-connected urban site, traditional construction often wins by 5–10%. The modular advantage shows up in remote conditions, where it can be 15–25% cheaper all-in once you count the real costs.

Where modular saves money in desert projects

  • Labor housing and transport: A traditional site needs camps, buses, catering, and medical for 200+ workers. Modular might need 50.
  • Financing: Shaving 12 months off a USD 20M build saves roughly USD 1–1.5M in interest and carrying costs.
  • Revenue capture: Opening a season earlier can mean USD 3–5M in additional first-year revenue for a boutique resort.
  • Change orders: Factory production forces early design lock, which virtually eliminates the 8–15% change-order creep typical of traditional builds.

Where modular does not save money

  • Highly irregular geometries: If every room is a different shape, you lose the factory repetition benefit.
  • Sites with cheap local labor and short hauls: Economics flip when on-site labor is USD 15/day and the factory is 2,000 km away.
  • Ultra-luxury bespoke finishes: If every suite needs hand-carved stone, much of that work happens on site anyway.

For the full carbon and lifecycle picture, our analysis of modular vs. traditional eco construction breaks down where the sustainability and cost curves intersect.

Designing for the Desert Guest Experience

One misconception worth killing: modular does not mean boxy and industrial. The structural grid is repetitive, but the guest-facing experience can be anything.

Effective desert modular hotels typically combine:

  • Repeated room modules that form the accommodation wings — this is where factory efficiency pays off.
  • Site-built public spaces — lobbies, restaurants, spas — where architectural drama matters and repetition does not.
  • Expressive facades applied over modular shells using rainscreen cladding, perforated aluminum screens, or sandstone-toned panels that visually dissolve the module joints.

For instance, a desert glamping operator might use identical 3m × 9m room modules internally — giving each guest the same premium bathroom, the same king bed, the same panoramic window — while the external cladding, roof form, and terrace design vary unit to unit to create the illusion of a hand-crafted cluster. Guests never notice the repetition. The owner gets factory economics.

Interior of a luxurious modular hotel suite with desert views
Interior of a luxurious modular hotel suite with desert views

Specialized transport truck carrying a prefab module across a desert highway
Specialized transport truck carrying a prefab module across a desert highway

What to Ask Your Modular Manufacturer Before Signing

Not all modular suppliers can handle remote desert projects. The capability gap between an urban modular specialist and one with genuine remote-site experience is enormous. Before you commit, get direct answers to these:

  1. Have you delivered modules to sites more than 100 km from a port or major city? Show me three. Ask for contact references, not renderings.
  2. What is your thermal performance specification, and has it been tested in conditions above 45°C? Generic European test data does not translate to Gulf summer.
  3. How do you handle differential thermal movement between modules? Modules expand and contract differently depending on sun exposure. Joint design matters.
  4. What is your sandstorm protocol during transport and assembly? A good supplier has one. A bad one improvises.
  5. What warranty do you offer on facade performance after 10 years of UV and sand exposure? Reputable manufacturers back their coatings; marginal ones do not.
  6. Can you show ISO 9001, ISO 14001, and CE compliance documentation? These are table stakes for any export project.

If you want to see how these questions are answered in practice, our project portfolio shows completed hospitality and remote-site deployments with their actual schedules and specifications.

Getting Started on a Desert Modular Project

The fastest path from idea to open doors goes something like this: lock your site, commission a transport route survey, engage a modular manufacturer at concept-design stage (not after drawings are done), and run site prep parallel to factory production. Do those four things and you will beat any traditional build on schedule, cost, and quality — often by a wide margin.

The owners who struggle with modular are the ones who treat it like traditional construction with a different name. It is not. It is a manufacturing process that happens to produce buildings, and the earlier you engage the factory, the more value you get.

If you are planning a resort, eco-lodge, or remote hospitality project and want to understand what is realistic for your site, budget, and timeline, the team at apexecobuilt has delivered modular hospitality projects in 80+ countries — including some of the harshest desert environments on the planet. Get in touch with a site brief and we will walk you through what a realistic schedule and spec looks like for your project. You can also explore our full range of modular and aluminum building solutions to see what is possible.
